Project at a Glance | |
Project Name | Texas GulfLink Deepwater Port |
Project Type | Deepwater crude oil export port |
Project Status | Federal Approval Vacated |
Project Location | Gulf of Mexico, offshore Freeport, Texas |
Developer | Sentinel Midstream LLC |
Loading Capacity (VLCC) | Fully loads VLCCs (about 2 million bbl each) offshore; maximum loading rate: 85,000 bbl/hr |
Nominal Capacity | 1.2 million barrels per day |
Project Overview
Texas GulfLink is a proposed deepwater crude oil export port about 30 miles off Freeport in Brazoria County, Texas. Sentinel Midstream developed the project through its affiliate Texas GulfLink, LLC. It is designed to load VLCCs fully offshore, removing the need to top off larger tankers with smaller vessels in shallow Gulf Coast channels.
The design combines two floating SPM buoys, a manned platform for monitoring, custody transfer metering, and surge relief, a 42-in. pipeline to shore, and an onshore tank farm near Jones Creek, Texas.
Sentinel says the terminal would use vapor recovery on a dynamically positioned vessel, which it estimates would prevent up to 19,000 tons of VOC emissions per year and cut emissions by about 86% versus reverse lightering.
The project advanced quickly in 2025–2026. A MARAD record of decision was received in February 2025. The project license was issued in early 2026. A USD 2.1 billion U.S.–Japan Trade Agreement funding announcement was made in February 2026. The construction work began in May 2026.
On 12 August 2026, the Fifth Circuit vacated the record of decision. The project's path forward depends on MARAD's remand decision and any further legal steps, none of which have been reported.
Texas GulfLink Project Location
Texas GulfLink is located in Brazoria County, Texas, with its onshore terminal near Jones Creek, west of Lake Jackson and Freeport. Its offshore deepwater crude-oil export terminal is in the Gulf of Mexico, about 30.5 miles off the Texas coast and west of Freeport.

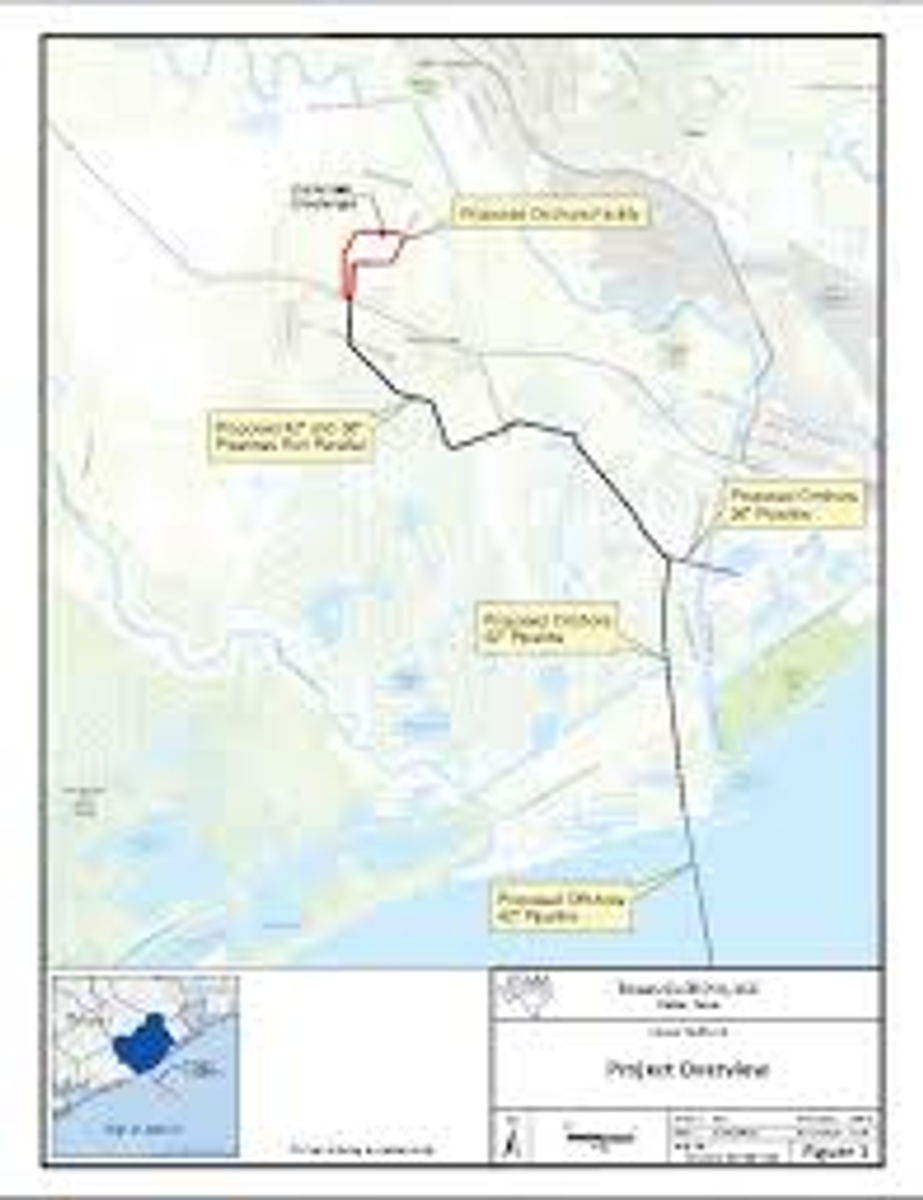

Texas GulfLink Project Map
Project Background
Texas GulfLink was one of three deepwater port applications for the Freeport area filed with MARAD in 2019, alongside SPOT and Texas COLT. Texas COLT later withdrew. MARAD approved SPOT in November 2022, and the Fifth Circuit upheld that approval in 2024.
MARAD issued its record of decision approving Texas GulfLink on 14 February 2025, announced by Sentinel on 18 February 2025. In January 2026, the Department of Transportation said MARAD was taking over deepwater port licensing from the Coast Guard, and the license followed on 29 January.
Texas GulfLink Project Status
On 12 August 2026, the U.S. Court of Appeals for the Fifth Circuit vacated MARAD's record of decision approving Texas GulfLink and remanded it. The court held that the application area must include the port's pipelines, and that a properly drawn area would overlap the already-approved SPOT project, breaching the Deepwater Port Act's one-port-per-application-area rule.
This came three months after Sentinel announced on 4 May 2026 that construction had started with USD 2.1 billion of funding under the U.S.–Japan Trade Agreement, targeting operations by Q4 2028. Sentinel declined to comment, and there was no appeal, rehearing petition, or MARAD remand action.
Trusted by Leading Manufacturers & EPCs
Find The Latest Crude Oil Refinery Plant Projects Around The World
Gain exclusive access to our industry-leading database of Crude Oil Refinery Plant Project opportunities with detailed project timelines & stakeholder information
No credit card Up-to-date coverage
Stakeholder Details
Stakeholder | Role |
Sentinel Midstream LLC | Developer; parent of Texas GulfLink LLC |
Cresta Fund Management | Sponsor/capital provider |
Government of Japan / U.S. Commerce Department | Funding under U.S.–Japan Trade Agreement |
MARAD | Licensing Authority |
Texas GulfLink Project Cost
The total estimated cost for the Texas GulfLink Project is approximately USD 2.1 billion. It is specified by Sentinel Midstream and the U.S. government in connection with the Japan-U.S. strategic investment agreement supporting the project.
Project Scope
The following is the project scope of the Texas GulfLink Project:
Onshore crude storage terminal: Texas GulfLink will build a terminal near Jones Creek in Brazoria County, Texas, with above-ground geodesic-dome storage tanks.
Inbound crude-oil pipeline: A 36-inch onshore pipeline will transport crude oil from Houston-area supply sources to the Jones Creek storage terminal.
Offshore export pipeline: A 42-inch offshore pipeline will carry crude oil from the Jones Creek terminal to the deepwater port in federal waters. It will terminate at the offshore loading system, enabling large-volume crude movement to tankers.
Deepwater terminal and SPM buoys: The offshore scope includes two catenary anchor leg mooring (CALM) single-point mooring (SPM) buoys. Tankers will connect to these buoys through floating hoses for loading.
Project Timeline
Year | Event |
2028 | Expected completion target of the project |
12 August 2026 | Fifth Circuit vacates MARAD record of decision and remands |
4 May 2026 | Sentinel announces Final Investment Decision and construction start |
29 January 2026 | Deepwater port license granted |
14 February 2025 | MARAD approves Texas GulfLink application; announced 18 February 2025 |
30 May 2019 | Texas GulfLink applies to MARAD for a deepwater port license |
Benefits
The following are the benefits of the project:
Significant reduction in emissions: Direct offshore loading of Very Large Crude Carriers (VLCCs) cuts overall emissions by about 86% and CO₂ emissions by about 83% compared with traditional reverse lightering.
Improved air quality for coastal communities: Loading occurs more than 30 miles offshore instead of near-shore ports, so emissions from lightering no longer affect portside areas. This delivers cleaner air for nearby communities.
Greater efficiency and lower export costs: Full loading of VLCCs in a single operation eliminates the need for inefficient, multi-step lightering with smaller vessels. This makes U.S. crude more competitive on global markets by reducing time, cost, and logistical friction
Reduced port congestion and better safety: By moving VLCC loading offshore, the project eases vessel traffic in near-shore waters and ship channels. This improves navigational safety and lowers the risk of incidents in busy coastal areas.
Conclusion
Texas GulfLink is a significant deepwater crude-oil export project, connecting Texas crude supplies in the Houston market with international VLCC markets. By combining an onshore Jones Creek storage terminal, offshore pipelines, and two offshore SPM loading buoys, the project creates a direct export route.
It is designed to fully load VLCCs at sea, with capacity of up to 1 million barrels per day and about 365 million barrels annually. It is expected to improve U.S. crude-export efficiency, reduce reliance on lightering operations, and ease vessel traffic in crowded ship channels.
Once operational, Texas GulfLink is anticipated to generate thousands of local and regional jobs and millions of dollars in revenue. The Texas GulfLink Project is positioned to become a major infrastructure asset for the Texas Gulf Coast and the broader U.S. crude-export system.
Track the Latest Crude Oil Refinery Plant Projects Around The World
Subscribe to our upcoming and ongoing Crude Oil Refinery Plant Projects in the World with ease to access reliable, high-quality insights on forthcoming and completed Projects across the country.
Our user-friendly platform provides essential details, timely updates, key stakeholder contact information, and business opportunities tailored for engineering companies, industry professionals, investors, and government agencies.
Start a free demo to take your business to the next level.
Leave a Comment
We love hearing from our readers and value your feedback. If you have any questions or comments about our content, feel free to leave a comment below.
We read every comment and do our best to respond to them all.
