FPSO Dorado Project: Bedout Sub-basin Offshore Western Australia

project_profile

FPSO Dorado Project: Bedout Sub-basin Offshore Western Australia

Updated on Sep 21, 2026, 07:07 PM IST
Written by Siddhi Jain



Project at a Glance

Project Name

FPSO Dorado Oil Development Project

Project Location

Bedout Sub-basin off the coast of Western Australia.

Project Status

Pre‑FID appraisal and concept‑refinement phase

Joint Venture

Santos Limited (80%, Operator), Carnarvon Energy (10%), OPIC Australia Pty Ltd (10%; ultimate holding company CPC Corporation, Taiwan)

Development Concept

Phase 1: oil and condensate production via a Wellhead Platform (WHP) tied back to a FPSO; associated gas reinjected to enhance liquids recovery. Phase 2 (future): development of the substantial regional gas resource, potentially backfilling Santos' WA domestic gas infrastructure

Original FPSO Target

Nganhurra, a vessel Santos had identified for Phase 1, with conversion planned to be performed by Seatrium in Singapore

FPSO Capacity

60,000–100,000 barrels per day (revised range); earlier disclosures cited 75,000–100,000 bpd

Resource Estimate

249 million barrels of light oil and condensate + 1.1 trillion standard cubic feet of gas

Project Overview

Dorado is a deferred oil, condensate, and gas development in the Bedout Sub-basin off the coast of Western Australia. It is operated by Santos (80%) in a joint venture with Carnarvon Energy (10%) and OPIC Australia (10%, a CPC Corporation Taiwan subsidiary).

Built in 2 phases, the Phase 1 concept centres on a wellhead platform tied back to a floating production, storage and offloading (FPSO) vessel designed to process, stabilise, store and offload light oil/condensate, with associated gas handling and reinjection, at initial rates of about 75,000–100,000 barrels of oil per day.

Phase 2 is built to recover and export the gas. It would require separate assessment under environmental regulatory approval processes, including a separate OPP, if considered commercially and technically viable.

Early estimates placed Phase 1 capital expenditure in the range of USD 2 billion, with first oil originally targeted around 2027–2028 subject to a final investment decision. However, in January 2025, Santos deferred the project by deciding not to proceed with FPSO acquisition or front-end engineering and design (FEED), pushing back the expected Final Investment Decision  (FID) and prompting a reassessment of the Bedout Basin resource base.

Carnarvon's January 2026 Quarterly Activities Report confirmed the joint venture's latest resource assessment: 249 million barrels of light oil and condensate plus 1.1 trillion cubic feet of gas on a gross 2C (contingent resource) basis for Dorado and surrounding fields, alongside substantial upside, approximately 1.6 billion barrels of liquids and 9 trillion cubic feet of gas on a mean prospective resource basis across the broader Bedout Sub-basin acreage.



FPSO Dorado Location

The FPSO Dorado is located in the Bedout Sub-basin. It is situated in Commonwealth waters approximately 140 km offshore from Port Hedland, Western Australia, within a water depth of approximately 70 to 120 m.

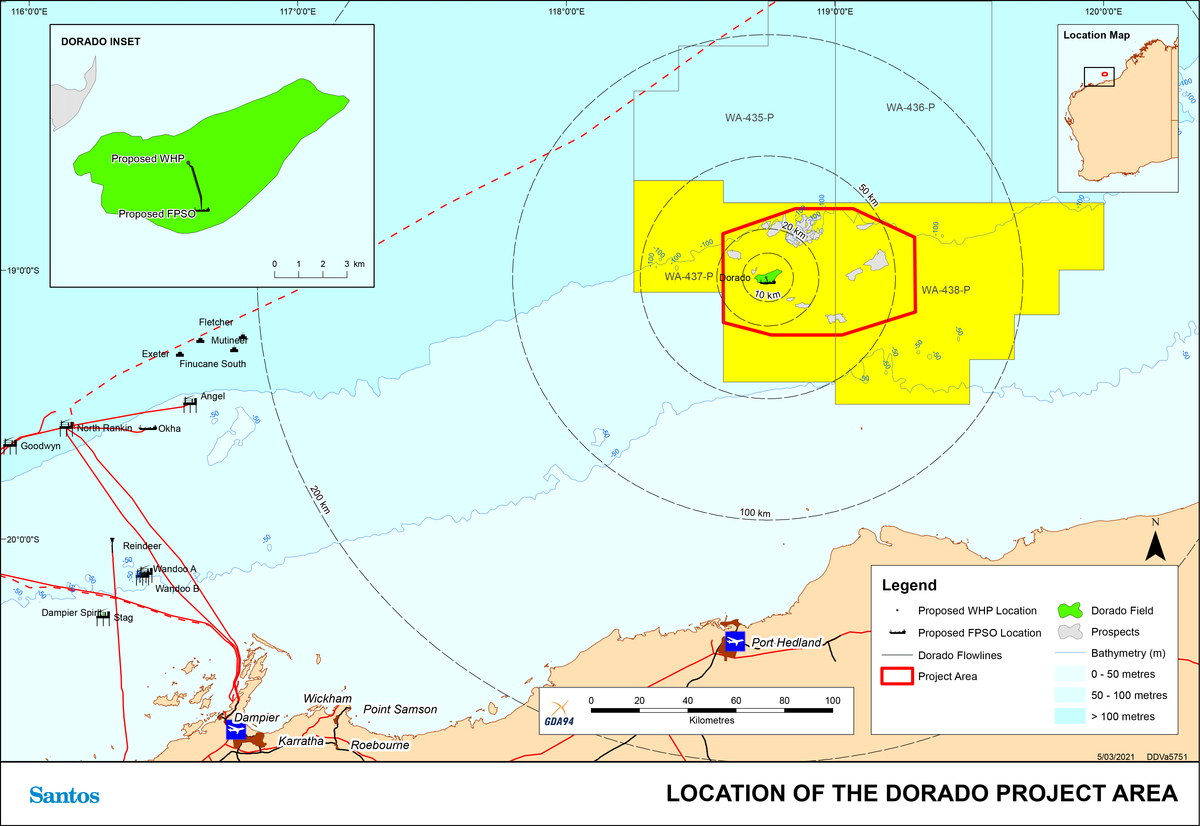

FPSO Dorado Map

FPSO Dorado Map



Technical Specification (Phase 1 Concept)

Development Concept

Wellhead Platform (WHP) + Floating Production, Storage and Offloading (FPSO) vessel, tied back subsea

Field Location

Permit WA-64-L, Bedout Sub-basin, offshore Western Australia

Distance Offshore

Approximately 140 km

Water Depth

70-120 m

FPSO Capacity (Design Range)

60,000–100,000 bpd; earlier disclosures cited 75,000–100,000 bpd

Gas Handling

Reinjection of associated gas in the initial phase to enhance oil and condensate recovery

Design Field Life

20 years

Original FPSO Concept

Conversion of an existing tanker hull, with new process equipment, turret, accommodation and utilities; later shifted to redeployment of an idle/donor FPSO hull (Nganhurra) for cost optimisation. This option is no longer available following its sale to BW Offshore

Project Background

The Phoenix exploration campaign led directly to the 2018 Dorado discovery, assessed at the time to hold approximately 162 million barrels of light oil and condensate plus 748 billion cubic feet of gas on a gross 2C contingent resource basis (a combined 344 million barrels of oil equivalent).

A 2019 appraisal programme de-risked the discovery, and Santos formally launched the Dorado FEED process in 2021 for both the FPSO and WHP work packages, following a competitive pre-FEED phase in which top-tier contractors were engaged. At that stage, Phase 1's estimated gross capital cost was approximately USD 2 billion, assuming a purchased FPSO.



Through 2023 and into mid-2024, the joint venture worked to re-validate and optimise the Phase 1 concept, reviewing phased drilling approaches and, most consequentially, FPSO redeployment and donor-hull conversion options, seeking to reduce the project's capital intensity below the original USD 2 billion guidance.

By July 2024, Carnarvon was reporting positive progress toward FEED re-entry later that year and a 2025 FID target, while the joint venture assessed several idle FPSOs, including the Nganhurra, as potential lower-cost alternatives to a full conversion or new-build.

On January 21, 2025, Santos announced it would not, after all, purchase the Nganhurra and would not enter FEED at that stage, deferring the 2025 FID target with no replacement date specified. The subsequent sale of the Nganhurra to BW Offshore, removing it entirely as a future Dorado option, underscored that this was not a pause but a genuine reset of the project's technical pathway.

In 2026, the Bedout Basin offshore Western Australia is moving into a real drilling phase. Regulators (NOPSEMA) have been told about a program that can drill up to seven exploration/appraisal wells between late 2026 and 2031. Santos has publicly said it is ready to start this multi‑well program from Q3 2026, subject to approvals.

Carnarvon Energy has already put money aside (about A$20 million from its cash balance) to pay for its share of a two‑well Bedout drilling campaign using the Transocean Equinox rig from around April 2027.

FPSO Dorado Current Status

Currently, the Dorado FPSO development in the Bedout Basin is not yet approved and remains in a pre‑FID appraisal and concept‑refinement phase. The joint venture’s own guidance indicates drilling will resume in the first half of 2027, with further development work contingent on evaluation of those results, implying that any renewed FID discussion is unlikely before late 2027 at the earliest.

Trusted by Leading Manufacturers & EPCs

Find The Latest FPSO Projects In Australia

Gain exclusive access to our industry-leading database of FPSO Project opportunities with detailed project timelines & stakeholder information

Request Free Trial Learn More

No Credit Card Up-to-date coverage



Stakeholder Details

Stakeholder Role

Organisation/Individual

Operator (80%)

Santos Limited

Partner (10%)

Carnarvon Energy Limited

Partner (10%)

OPIC Australia Pty Ltd

Planned FPSO Conversion Yard (Historical)

Seatrium, Singapore

Subsea FEED Contractor (Historical)

Atteris

Regulatory Authority

NOPSEMA (National Offshore Petroleum Safety and Environmental Management Authority)



FPSO Dorado Project Cost

Cost/Finnacial Items

Details

Phase I Gross Capital Cost

Approximately USD 2 billion

Carnarvon Development Cost Carry

USD 90 million

Carnarvon Cash Position (January 2025)

Over AUD 180 million (approximately USD 128 million) cash in bank

Carnarvon Cash Position (March 2026)

Approximately AUD 98 million(approximately 70 million) cash reserves



Project Timeline

Year

Event

H1 2027

Drilling activity in the Bedout region expected to resume

February 2026

Santos' plans for up to seven exploration and appraisal wells in the Bedout Basin are under NOPSEMA assessment

January 2026

Carnarvon states drilling activity in the region is expected to resume in the first half of 2027, with the USD 90 million Dorado development cost remaining available.

21 January 2025

SANTOS DEFERS FID AGAIN. It decides not to purchase the Nganhurra FPSO and not to enter FEED at this stage, deferring the 2025 FID target with no replacement date specified

2023-2024

Joint venture re-validates the Phase 1 concept; evaluates phased drilling

1 September 2023

Carnarvon publishes updated resource estimates for the broader Bedout Sub-basin, cited in subsequent reports as the basis for the 1.6 billion barrels / 9 Tcf

August 2022

Santos postpones the Dorado project, citing inflationary costs

2021

Santos launches Dorado FEED for the FPSO and WHP work packages

2019

Appraisal drilling programme de-risks the Dorado discovery



Conclusion

The FPSO Dorado Project represents Australia’s largest undeveloped oil discovery, with a phased development strategy designed to deliver 249 million barrels of light oil and condensate + 1.1 trillion standard cubic feet of gas resources in the Bedout sub-basin offshore Western Australia.

After years of delays and repeated deferrals of the FID, the project has regained strategic importance amid regional energy-security concerns and elevated oil prices, positioning it as a potential cornerstone of domestic liquids supply.
