Oracle Details 2.45 GW Fuel-Cell Plan for Project Jupiter in New Mexico, US

project_news

Oracle Details 2.45 GW Fuel-Cell Plan for Project Jupiter in New Mexico, US

Updated on Oct 23, 2026, 01:34 AM IST
Written & Edited by Harikesh VA

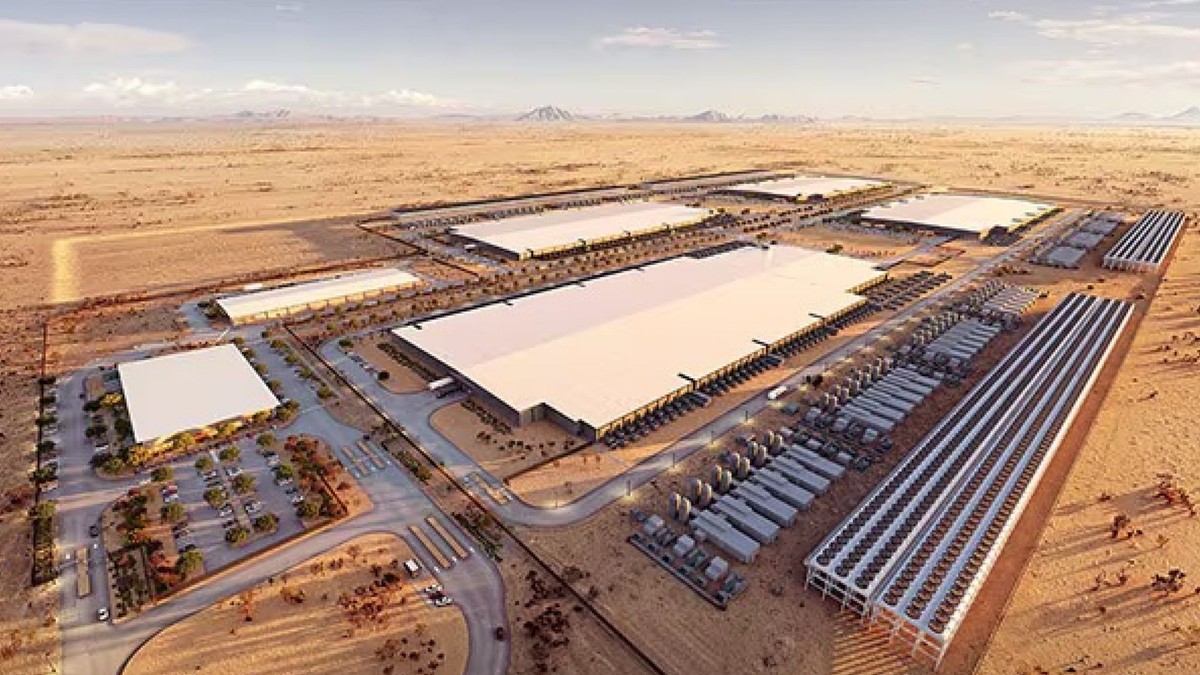

Oracle's Project Jupiter, an AI data center campus located in Doña Ana County's Paso del Norte border airshed in New Mexico, has released an updated energy plan that the company says will substantially reduce nitrogen oxide emissions compared with previous designs, use a negligible amount of water, and generate power through a private microgrid.



According to an Oracle blog post published October 22, 2026, the campus will not require New Mexico utility customers to fund new generation, transmission, or distribution infrastructure for the project.

A Revised Energy Design for the Border Data Center

The revised design replaces the natural-gas turbines and diesel backup generators previously planned for the site with solid oxide fuel cells manufactured by Bloom Energy.



Because fuel cells generate electricity through an electrochemical reaction rather than combustion, Oracle says they substantially reduce the formation of nitrogen oxides, a key contributor to regional ozone. Fuel cells also operate more efficiently than simple-cycle turbines, meaning less fuel is consumed and less carbon dioxide is emitted for each megawatt-hour delivered.



Capacity and Water Considerations in a Scarce Region

The fuel-cell microgrid will provide up to 2.45 gigawatts of installed capacity for the campus while using a negligible amount of water. Oracle characterized the water question as an important consideration in a water-scarce region.



The company states that all of these benefits are achieved without requiring additional grid or generation infrastructure, with any project-related power costs privately funded and without impacts to utility customers.

Trusted by Leading EPCs & Manufacturers

Find the Latest Data Center Projects in the United States

Gain exclusive access to our industry-leading database of data center opportunities with detailed project timelines and stakeholder information

Request Free Trial → Learn More →

No credit card Up-to-date coverage



Legal Framework and Private Funding

New Mexico's 2025 Advanced Grid Technology Act allows qualifying microgrids to serve large loads separately from the public grid and requires that the energy they generate and sell come from net-zero-carbon resources by 2045. Oracle's blog post presents the revised design as aligning with that framework.

"The revised Project Jupiter design reflects the outcome New Mexico's microgrid framework was intended to produce: cleaner technology, private capital bearing private costs, and infrastructure that strengthens rather than strains the grid," wrote Archie Fallon, a partner at Willkie Farr & Gallagher, in recent comments submitted to the New Mexico Environment Department.



Fallon is former counsel for Yucca Growth Infrastructure, which develops behind-the-meter power infrastructure for large-load customers in the Southwest and is a Project Jupiter partner.

Commitment to Responsible Development

The blog post closes by stating that Project Jupiter remains committed to developing responsibly, protecting New Mexico's resources, and engaging transparently with the community.



The announcement lays out the company's position on emissions, water use, and cost allocation as the project proceeds through review by New Mexico's environmental regulators.

Which Hyperscale Builds Will Reshape America's Digital Backbone?

The United States is racing to add gigawatts of data center capacity, and the winners will be the firms that spot opportunities before they become headlines. Staying ahead means knowing which campuses are moving from concept to construction, which tenders are live, and where capital is flowing next.



The Global Project Tracking (GPT) platform by Blackridge Research gives you a real-time window into the data center pipeline across the United States, from early-stage announcements to commissioning. Every project profile is enriched with timelines, stakeholders, and development status so your team can act with confidence.



Whether you sell equipment, provide EPC services, or invest in digital infrastructure, intelligence is your edge.



  • Upcoming Projects

  • Tender Notices

  • Contract Awards

  • Projects Under Construction

  • Completed Projects



Book a Free Demo of the Global Project Tracking (GPT) platform by Blackridge Research and put the entire United States data center pipeline at your fingertips.

Tags

Leave a Comment

We love hearing from our readers and value your feedback. If you have any questions or comments about our content, feel free to leave a comment below.

We read every comment and do our best to respond to them all.

Protected by Cloudflare Turnstile
