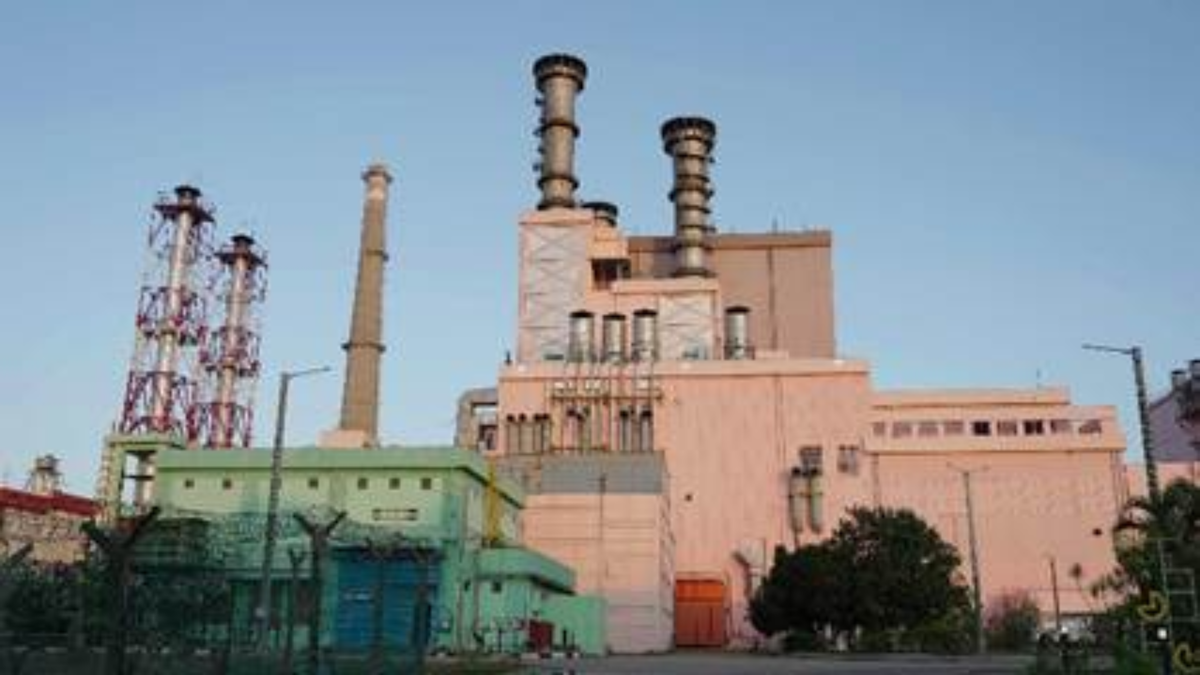

Prototype Fast Breeder Reactor (PFBR) Project - Kalpakkam, India
Table of Contents
- Loading contents...
Project at a Glance | |
Project Name | Prototype Fast Breeder Reactor (PFBR) |
Project Type | Nuclear Power Plant - Liquid Metal Fast Breeder Reactor (LMFBR) |
Project Sub-Type | Sodium-Cooled Pool-Type Fast Breeder Reactor |
Project Status | Criticality Achieved - Commissioning Phase (April 2026) |
Project Location | Kokkilamedu, Kalpakkam, Chengalpattu District, Tamil Nadu, India (approx. 70 km south of Chennai) |
Project Owner / Developer | Bharatiya Nabhikiya Vidyut Nigam Limited (BHAVINI) |
Installed Capacity | 500 MWe (electrical) / 1,250 MWth (thermal) |
Design Life | 40 years at 75% load factor |
Total Expenditure (as of Feb 2021) | Rs 6,840 crore (approx. USD 908 million) |
Construction Start | 2004 |
Criticality Achieved | 6 April 2026 |
Full Power Generation Target | December 2026 |
Programme Stage | Stage II of India's Three-Stage Nuclear Power Program |
Indigenous Content | Fully indigenous - no foreign technology transfer (DAE) |
Industry Participation | 200+ Indian industries, including MSMEs |
Global Significance | India becomes the 2nd country after Russia to operate a commercial-scale Fast Breeder Reactor |
Project Overview
The Prototype Fast Breeder Reactor (PFBR) is India's first indigenous sodium-cooled fast breeder reactor, located at Kokkilamedu adjacent to the Madras Atomic Power Station in Kalpakkam, Tamil Nadu. The reactor reached criticality on 6 April 2026, sustaining a controlled nuclear chain reaction for the first time.
The PFBR is a pool-type liquid metal fast breeder reactor rated at 500 MWe. Unlike conventional thermal reactors, it uses unmoderated fast neutrons to convert non-fissile uranium-238 into fissile plutonium-239, a process known as breeding.
The reactor produces more fissile fuel than it consumes, which is the defining characteristic of a breeder reactor and the strategic reason for its importance to India's long-term energy security.
India holds approximately one to two percent of global uranium reserves but around 25 percent of global thorium deposits. The Fast Breeder Reactor in India bridges the gap between the country's limited uranium stock and its vast thorium resources.
Plutonium bred in the PFBR will be used in future fast breeder reactors, while thorium blankets inserted in later operation will produce uranium-233 for use in third-stage advanced heavy water reactors.
BHAVINI (Bharatiya Nabhikiya Vidyut Nigam Limited) was incorporated on 22 October 2003 as a wholly owned Government of India enterprise under the Department of Atomic Energy. It was established specifically to build and operate fast breeder reactors as part of India's nuclear program. The PFBR is BHAVINI's flagship project and the first commercial-scale fast breeder reactor built outside Russia.
40+ reviews
Find the Latest Nuclear Power Plant (NPP) Project Contract Awards Database in India
Gain exclusive access to our industry-leading database of Nuclear Power Plant (NPP) opportunities with detailed project timelines and stakeholder information.
Collect Your Free Leads Here!
No credit cardUp-to-date coverage
Joined by 750+ industry professionals last month
Technical Specifications
Reactor Type | Pool-Type Sodium-Cooled Fast Breeder Reactor (LMFBR) |
Electrical Output | 500 MWe |
Thermal Output | 1,250 MWth |
Primary Coolant | Liquid Sodium - 1,750 tonnes |
Coolant Loops | 2 primary sodium loops, 2 secondary sodium loops, 4 steam generators per loop |
Primary Fuel (Initial) | Uranium-Plutonium Mixed Oxide (MOX) - PuO₂ + UO₂ |
Blanket Material (Initial) | Uranium-238 |
Blanket Material (Future) | Thorium-232 (to breed U-233 for Stage III reactors) |
Fuel Assembly Shape | Hexagonal sub-assemblies |
Reactor Safety | Passive safety systems - inherently safe design; no reliance on active cooling in emergency |
Design Life | 40 years |
Load Factor (Design) | 75% |
Site Area | Co-located with Madras Atomic Power Station, Kokkilamedu |
Control Sub-Assemblies | Inserted from March 2024 (phased core loading) |
Nuclear Fuel Loading | Final fuel loading began on 18 October 2025 |
Project Background and Development History
Design work on the PFBR began at IGCAR in the 1980s as a prototype for a 600 MWe commercial fast breeder reactor. The design drew directly on India's experience operating the Fast Breeder Test Reactor (FBTR) at Kalpakkam, which was built in the 1970s, modeled on the French RAPSODIE reactor.
The FBTR gave Indian scientists hands-on experience with liquid sodium coolant systems and the materials science required for fast reactor conditions. The government sanctioned the PFBR project in September 2003 at an estimated cost of Rs 3,492 crore with a target completion date of September 2010. Construction began in 2004.
Delays driven by first-of-a-kind technical challenges in the sodium coolant circuits and procurement bottlenecks pushed completion well beyond the original schedule. The revised estimate of Rs 5,677 crore was sanctioned in April 2012, with a revised commercial operations target of March 2015. By February 2021, cumulative project expenditure stood at Rs 6,840 crore.
A 2014 Comptroller and Auditor General audit found that BHAVINI had been over-reliant on NPCIL for high-value component procurement, with 100 out of 131 audited high-value purchase orders delayed by between one day and 1,092 days.
Atomic Energy Minister Jitendra Singh, in a written reply to the Lok Sabha, acknowledged that delays were due to first-of-a-kind technological issues in the integrated commissioning phase, and stated these were being solved systematically in coordination with IGCAR designers.
In August 2023, BHAVINI filled the main vessel with approximately 1,150 tonnes of liquid sodium in five days. All indigenous primary and secondary sodium pumps were commissioned, and integrated commissioning advanced significantly. The first phase of core loading commenced on 4 March 2024 with Prime Minister Narendra Modi present.
Final regulatory clearance for fuel loading was granted on 31 July 2024. Final fuel loading began on 18 October 2025, and criticality was achieved on 6 April 2026.
Key Stakeholders
Stakeholder Role | Organisation |
Project Owner & Operator | Bharatiya Nabhikiya Vidyut Nigam Limited (BHAVINI) |
Reactor Designer | Indira Gandhi Center for Atomic Research (IGCAR) |
Policy & Administrative Authority | Department of Atomic Energy (DAE), Government of India |
Nuclear Safety Regulator | The Atomic Energy Regulatory Board (AERB) is an independent statutory body |
Fuel Manufacturer | Advanced Fuel Fabrication Facility (AFFF), Tarapur |
Equipment & Technology Supplier | Bharat Heavy Electricals Limited (BHEL) |
Industry Contributors | 200+ Indian companies (including MSMEs) |
First-Stage Fuel Supplier (Pu source) | Nuclear Power Corporation of India Limited (NPCIL) |
India's Three-Stage Nuclear Program Context
The PFBR is the central facility of Stage II of India's three-stage nuclear power program, a framework developed by Dr. Homi Jehangir Bhabha in the 1950s to make India energy-independent through sequential exploitation of uranium and thorium resources.
Stage | Reactor Type | Fuel / Function | Status (2026) |
Stage I | Pressurized Heavy Water Reactors (PHWRs) | Natural uranium fuel produces plutonium-239 as a by-product | Operational with 8.78 GW installed capacity |
Stage II | Fast Breeder Reactors (FBRs) | MOX (Pu+U) fuel, breeds more Pu-239 from U-238 blanket, future: Th-232 blanket breeds U-233 | Criticality achieved: PFBR Kalpakkam, April 2026 |
Stage III | Advanced Heavy Water Reactors (AHWRs) | Thorium-plutonium fuel, breeds U-233 from Th-232, closed thorium-uranium cycle | Design/development stage |
Project Milestones and Timeline
1950s: Homi Jehangir Bhabha formulates India’s three-stage nuclear power program, laying the foundation for a long-term energy strategy.
1970s: The Fast Breeder Test Reactor (FBTR) is built at Kalpakkam, becoming India’s learning base for sodium-cooled reactor technology.
2003: The government sanctions the PFBR project, and BHAVINI is established as the implementing agency.
2004: Construction of the Prototype Fast Breeder Reactor (PFBR) begins at Kalpakkam.
2012: The government approves a revised project cost of Rs 5,677 crore, reflecting delays and first-of-a-kind technical challenges.
4 March 2024: Narendra Modi visits Kalpakkam and marks the start of core loading, a crucial pre-commissioning step.
6 April 2026: The PFBR achieves criticality, marking India’s entry into Stage II of its nuclear program and making it the second country after Russia to operate a commercial-scale fast breeder reactor.
Project Cost and Investment
Cost Item | Details |
Original Sanctioned Cost | Rs 3,492 crore (approx. USD 420 million at 2003 rates) was sanctioned in September 2003 |
Revised Sanctioned Cost | Rs 5,677 crore (approx. USD 680 million at 2012 rates) sanctioned in April 2012 |
Cumulative Expenditure (Feb 2021) | Rs 6,840 crore (approx. USD 908 million) |
Cost Overrun | Approximately 96% over the original sanction |
Funding Mode | Government of India, public sector |
Revenue (Post-Commissioning) | Not yet generating revenue |
Expansion Plans and Future Fast Breeder Reactor Program
Following satisfactory performance of the PFBR, the DAE plans to construct two additional 500 MWe Fast Breeder Reactors at Kalpakkam, designated FBR 1 and FBR 2. A parliamentary reply published by PIB in January 2026 confirmed that the government had accorded approval for pre-project activities for the twin-unit FBR 1 and FBR 2 facility. Financial sanctions will be sought after the PFBR achieves first criticality, which has now occurred.
IGCAR is designing the FBR-600, also called the Indian Fast Breeder Reactor (IFBR) or Commercial Fast Breeder Reactor (CFBR), a 600 MWe successor to the PFBR. Current plans involve building six FBR-600 units in twin-unit configurations to share common auxiliaries. The first twin unit is planned at the BHAVINI campus at Madras Atomic Power Station, Kalpakkam.
India's Nuclear Energy Mission, announced in the Union Budget 2024-25, targets 100 GW of nuclear-generated electricity by 2047. BHAVINI's fast breeder reactor program is allocated 3.80 GW within this roadmap, per parliamentary data from March 2026. India's installed nuclear capacity stood at 8.78 GW as of early 2026, with projects under construction and pre-project stages expected to raise this to 22 GW by 2031-32.
Project Benefits and Achievements
India has joined Russia as one of the only nations operating a commercial-scale fast breeder reactor, marking a major milestone in nuclear technology. The Prototype Fast Breeder Reactor (PFBR) stands out as a global landmark, reinforcing India’s position in advanced nuclear energy development.
The PFBR operates on a closed nuclear fuel cycle, allowing the recovery of both fissile and fertile materials from spent fuel. This process significantly reduces high-level radioactive waste while maximizing fuel efficiency, making it a more sustainable approach to nuclear power generation.
India’s nuclear strategy is shaped by its limited uranium resources, which account for only 1-2% of global reserves, contrasted with its vast thorium reserves of around 25%. The PFBR plays a critical role in bridging this gap by breeding plutonium from uranium-238 and paving the way for producing uranium-233 from thorium-232 in later stages.
A key highlight of the PFBR is its fully indigenous development. Built without foreign technology transfer or collaboration, the project involved contributions from over 200 Indian industries, aligning closely with the Aatmanirbhar Bharat initiative.
Conclusion
The Prototype Fast Breeder Reactor (PFBR) at Kalpakkam marks a defining shift in India’s nuclear energy journey, transitioning the country into Stage II of its long-term three-stage program envisioned by Homi Jehangir Bhabha. India has now demonstrated its capability to design, build, and operate a complex, fully indigenous fast breeder reactor at a commercial scale.
Beyond its technical milestone, the PFBR plays a strategic role in addressing India’s resource constraints by enabling efficient utilization of uranium while unlocking the long-term potential of its vast thorium reserves. The project also reinforces domestic industrial capability, with extensive participation from Indian companies and no reliance on foreign technology.
