Pudimadaka Green Hydrogen Hub

project_profile

Pudimadaka Green Hydrogen Hub

Updated on Feb 06, 2026, 01:44 PM IST
Written by shivam

Project Overview

NTPC Pudimadaka green hydrogen hub

The Pudimadaka Green Hydrogen Hub (NGEL Green Hydrogen Hub) is being developed by NTPC Green Energy Limited, a subsidiary of NTPC Ltd, and NREDCAP (New & Renewable Energy Development Corporation Of A.P. Ltd), the renewable arm of the Govt of Andhra Pradesh.

It is being developed as the first Green Hydrogen Hub under the National Green Hydrogen Mission near Pudimadaka village in Anakapalle district, close to Vishakhapatnam, in Andhra Pradesh.

It is being built with an investment of INR 1.85 lakh crore to produce 1500 TPD (tonnes per day) of green hydrogen and 7500 TPD green hydrogen derivatives including Green Methanol, Green Urea, and Sustainable Aviation Fuel). This project is one of the top upcoming renewable energy projects in India.

Project Background

NTPC Pudimadaka green hydrogen hub

The NGEL Green Hydrogen Hub is planned across 1200 acres as a one-stop solution for green chemicals and sustainable manufacturing. Once fully operational, the hub will harness 7 GW of renewable energy and export over 2.5 million tons of green chemicals annually.



The Andhra Pradesh government allocated 1,200 acres of land at Pudimadaka in 2014 for setting up a 4,000 MW thermal plant however, this project was shelved in 2018 due to the Union Government's decision to reduce coal imports. After the visit by Fortescue Future Industries (FFI) a green energy arm of Fortescue Group of Australia in September 2022, the project of green hydrogen was proposed. Over time, NTPC has revised and proposed the green hydrogen hub.



On 21st February 2025, NTPC Green Energy Limited (NGEL) and Andhra Pradesh Industrial Infrastructure Corporation (APIIC) signed a Land Lease Agreement. On 8th January 2025, Prime Minister Narendra Modi laid the foundation stone for this project.

Project Location

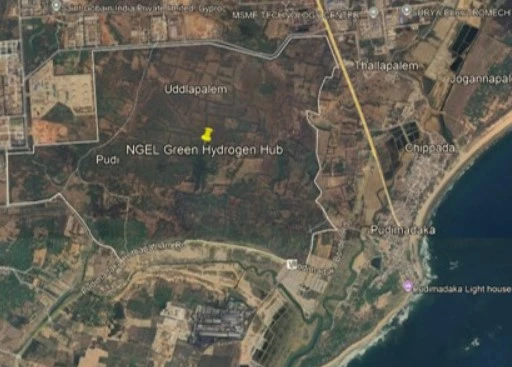

NTPC Pudimadaka green hydrogen hub location

The hub is located in Pudimadaka, Atchutapuram mandal, Anakapalle district, Andhra Pradesh, approximately 50 km from Visakhapatnam. It is 44 km from the Visakhapatnam Airport, and close to Gangavaram and Visakhapatnam Seaports.

Measurement

Value

Latitude

17°30'05.1"N (17.5014°)

Longitude

82°59'03.0"E (82.9842°)



Find the Latest Green Hydrogen Projects in India

Gain exclusive access to our database with project timelines and stakeholder info.

Collect Your Free Leads Here!

👥👥👥 Joined by 750+ industry professionals last month

Pudimadaka Green Hydrogen Hub Cost

The total project cost is estimated at INR 1.85 lakh crore (USD 22 billion). This NGEL green hydrogen hub is planned as an integrated hub for green chemicals and sustainable manufacturing in India.

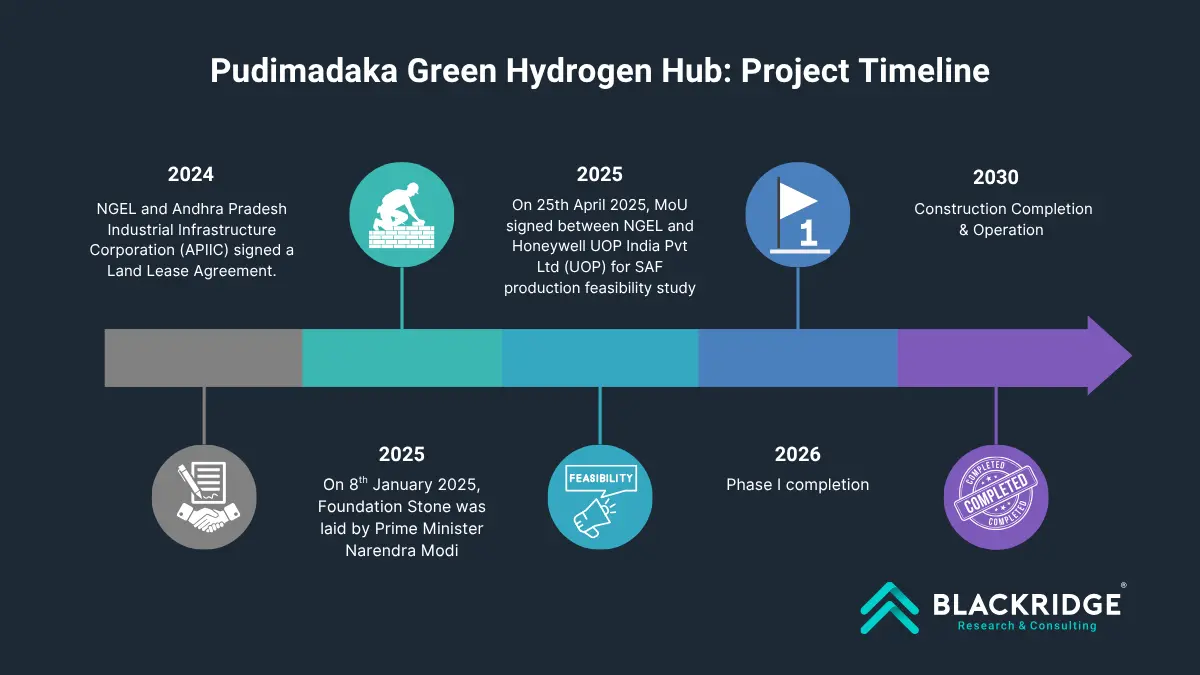

Project Timeline

NTPC Pudimadaka green hydrogen hub

Pudimadaka Green Hydrogen Hub Project Timeline Breakdown

Phase

Category

Component

Timeline

Phase 1 (Foundational)

Infra Development

Land, Road, Landscaping

2025-2026

Office, Gate complexes

Water tank, Fire fighting

Sewage treatment, Waste management

Phase 2 (Initial Build)

Electrical Infra

Trans Corridor Ph I / II (2.5 GW)

2025-2027

Water

20 MLD Fresh Water

5 MLD ETP Outlet Water

Electrical Infra

GIS Ph I - 2.5 GW

Phase 3 (Major Systems)

Water

95 MLD Desalination

2026-2032

Captive Jetty (Port)

Jetty to handle VLAC (Very Large Ammonia Carrier), VLCC (Very Large Crude Carrier)

2027-2029

Chemical Storage

1,00,000 MT Storage

Phase 4 (Expansion & Completion)

Electrical Infra

GIS Ph II - 2.5 GW

2028-2032

Trans Corridor Ph III (2 GW)

2029-2030

GIS Ph III - 2 GW

Green Chemicals

NETRA Projects

2025-2032

Ammonia

Methanol

SAF/Urea

  • Phase I: Phase I of the project is scheduled for completion by 2026, focusing on establishing core infrastructure and initiating production.

  • Phase II: Phase II includes electrical and water works and targets completion by 2027, expanding production capacities and derivative outputs.

  • Full Completion: The project is expected to be completed and fully operational by 2032.

Project Specifications

Production

Capacity (tonnes/day)

Green Hydrogen

1,500

Green Ammonia

4,500

Green Methanol

1,500

SAF/Green Urea

1,500

The Pudimadaka green hydrogen hub project will include the development of a manufacturing facility, a green chemical zone, a chemical storage terminal, port infrastructure, a transmission corridor, a 7 GW substation, an 80 MLD desalination plant, an effluent treatment plant, and other relevant facilities.

The project will receive power supply through the 400kV NTPC Simhadri and 800/765kV Anakapalli substations, along with associated transmission lines. Freshwater requirements will be met via the Andhra Pradesh Industrial Infrastructure Corporation (APIIC) network, including the Yeleru Canal.

Companies Involved in Pudimadaka Green Hydrogen Hub

Company

Role

NGEL

Developer

NREDCAP (New & Renewable Energy Development Corporation Of A.P. Ltd)

Developer

SMEC India Pvt Ltd

Design and Engineering Services

Honeywell UOP India Pvt Ltd (UOP)

SAF Production Feasibility Study

Andhra Pradesh Industrial Infrastructure Corporation (APIIC)

Land Allotment

Investors

The entire project is estimated at INR 1.85 lakh crores (USD 22 billion), and the cost of Phase I of the NTPC green hydrogen hub is estimated at INR 1.1 lakh crores which is to be invested by the National Thermal Power Corporation (NTPC).

Pudimadaka Green Hydrogen Hub Project Status (2025)

NTPC Pudimadaka green hydrogen hub

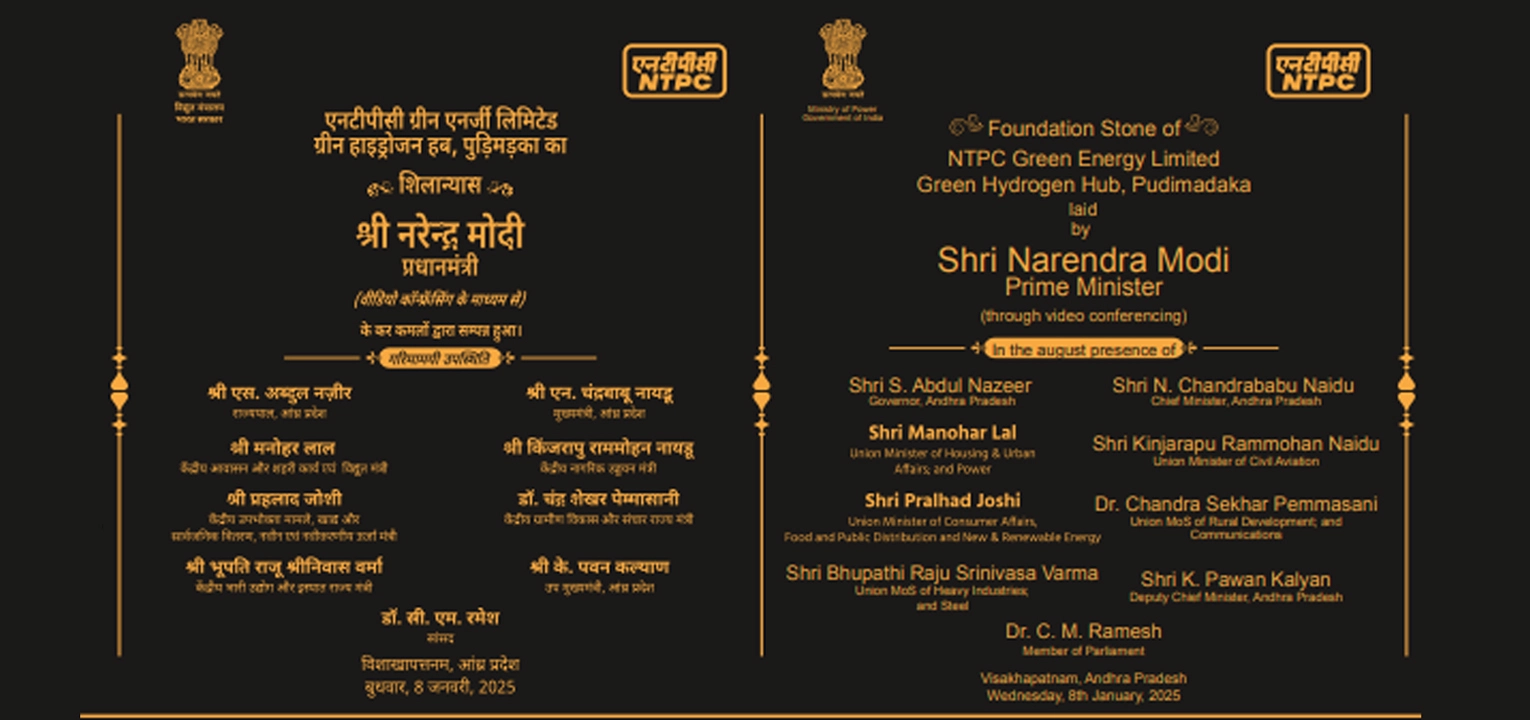

The foundation stone was laid by Prime Minister Narendra Modi on 8th January 2025. A Memorandum of Understanding (MoU) was signed between NTPC Green Energy Limited (NGEL) and Honeywell UOP India Pvt Ltd (UOP) to explore the production of SAF (Sustainable Aviation Fuel) by conducting a feasibility study using Honeywell’s proprietary eFining™ technology and CO2 emissions captured from NTPC's power plants and green hydrogen.

Find the Latest Green Hydrogen Projects in India

Gain exclusive access to our database with project timelines and stakeholder info.

Collect Your Free Leads Here!

👥👥👥 Joined by 750+ industry professionals last month

Benefits

Economic Impact: About 57,000 jobs will be created during the construction of this project boosting local employment and economic growth opportunities.



Demand Potential: Once operational Pudimadaka Green Hydrogen Hub will be an integrated hub for green chemicals and sustainable manufacturing in India. Its connectivity to seaports holds potential for domestic and export of green hydrogen and its derivatives in national and international markets.

Endorsement by MNRE (Ministry of New and Renewable Energy): This project is India's first green hydrogen hub supported by the MNRE under the National Green Hydrogen Mission.



Environmental Impact: Powered by renewables production of green hydrogen and its derivates assures the reduction of CO2 emissions and helps meet India its Net Zero 2070 goals.

Summary

The Pudimadaka Green Hydrogen Hub is a 7 GW project jointly developed by NTPC Green Energy Limited (NGEL), and NREDCAP (New & Renewable Energy Development Corporation Of A.P. Ltd). It is being developed near Pudimadaka village in the Anakapalle district, close to Vishakhapatnam, in Andhra Pradesh.

This project is being developed under the National Green Hydrogen Mission at an investment cost of INR 185,000 crores (USD 22 billion), and once operational, it will produce 1500 TPD of green hydrogen and 7500 TPD of green hydrogen derivatives (including Green Methanol, Green Urea, and Sustainable Aviation Fuel).

In January 2025 the foundation stone was laid and a MoU was signed to conduct the feasibility study of SAF production at the Pudimadaka site. Once completed and operational, the Pudimadaka green hydrogen hub will be an integrated hub for green chemicals and sustainable manufacturing in India.
