Project at a Glance | |
Project Name | Delhi Metro Phase V |
Project Type | Greenfield |
Project Sector | Infrastructure |
Project Sub Sector | Railway Infrastructure |
Project Status | Project Approved |
Project Cost (Phase V (A)) | INR 12014.91 crore (approximately USD 1.33 billion) |
Length | 16.076 km |
Total Stations | 13 (10 underground & 3 elevated) |
Developer | Delhi Metro Rail Corporation (DMRC) |
Corridors |
|
Project Overview
The Delhi Metro Phase V project, developed by the Delhi Metro Rail Corporation (DMRC), was approved in December 2025. The under-construction project will be built in two phases: Delhi Metro Phase V (A) and Delhi Metro Phase V (B).
As part of Phase V (A), it will add three new corridors, namely:
R.K. Ashram Marg to Indraprastha
Aerocity to IGD Airport T-1
Tughlakabad to Kalindi Kunj
Upon completion, the railway line will be 16.076 km long, further improving connectivity within Delhi, the national capital. It provides easy access to Kartavya Bhawans, offering doorstep connectivity to office-goers and visitors in this area. It benefits nearly 60,000 office-goers and 2 lakh visitors daily.
The railway line would also provide environmental benefits by reducing pollution and fossil fuel use and improving the quality of life. It will further boost the economy by extending the Delhi Metro network into Central Delhi and to the Domestic Airport.
Delhi Metro Phase V(B) is a major planned expansion of the Delhi Metro network approved by the Delhi Government on May 2, 2026, and currently awaiting final clearance from the Union Cabinet. It will add 7 new corridors with a total length of 97.16 km.
Project Background
The Delhi Metro is the largest and busiest metro network in India and one of the largest in the world. It involves nine operational lines with several extension projects underway.
Currently, 12 Metro lines, totaling nearly 395 km and 289 stations, are operated by the Delhi Metro Rail Corporation (DMRC) in Delhi and NCR.
Delhi Metro’s Phase 4 was planned to ensure last-mile connectivity to various localities in the National Capital Region (NCR).
As Delhi grows, the Delhi Metro Rail Corporation (DMRC) has planned Delhi Metro Phase V to boost connectivity within the city. It met the need for infrastructure and public transport.
As the next stage in expansion, Phase V will focus on addressing the demands driven by population growth, economic activity, and seamless connectivity in underserved or high-traffic areas.
Trusted by Leading Manufacturers & EPCs
Find The Latest Railway Infrastructure Projects In India
Gain exclusive access to our industry-leading database of Railway Infrastructure Project opportunities with detailed project timelines & stakeholder information
No credit card Up-to-date coverage
Delhi Metro Phase V Status
The project is being implemented in two parts: Phase V(A), which has been approved and is progressing, and Phase V(B), which remains at the planning/approval stage. The R.K. Ashram Marg–Indraprastha corridor is under construction, while the Aerocity–Terminal 1 and Tughlakabad–Kalindi Kunj corridors are in the tendering stage. The official target is completion in stages by September 2029.
The corridors are Dhansa Bus Stand–Nangloi, Central Secretariat–Kishangarh, Samaypur Badli–Narela, Kirti Nagar–Palam, Jor Bagh–Mithapur, Shastri Park–Mayur Vihar Phase III, and Keshavpuram–Rohini Sector 34. Four priority corridors are targeted for completion by 2029, subject to approvals and implementation timelines.

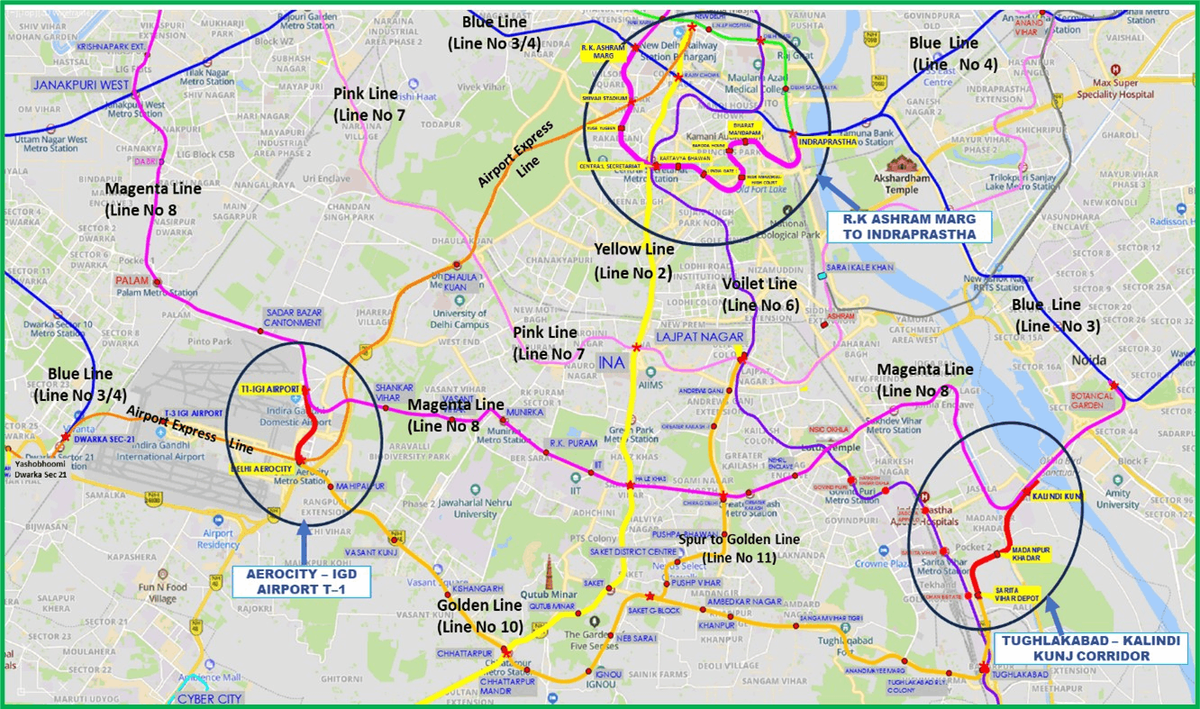

Delhi Metro Phase V Route Map
Delhi Metro Phase V Connectivity Corridors
Delhi Metro’s Phase V expansion is divided into Phase V(A), comprising three sanctioned corridors, and Phase V(B), comprising seven proposed corridors announced by the Delhi government in May 2026. Together, they are intended to extend metro connectivity across central, west, south, east, and north Delhi, as well as improve airport access.
Delhi Metro Phase V(A)
The Union Cabinet approved the three new corridors -
R.K. Ashram Marg to Indraprastha (9.913 km)
Aerocity to IGD Airport T-1 (2.263 km)
Tughlakabad to Kalindi Kunj (3.9 km)
These extension corridors include 13 stations, of which 10 are underground, and three are elevated.
As part of Phase V (A), the R.K. Ashram Marg to Indraprastha section will be an extension of the Botanical Garden-R.K. Ashram Marg corridor. It will connect the Central Vista area, which is currently under redevelopment.
The Aerocity - IGD Airport Terminal 1 and Tughlakabad - Kalindi Kunj sections are an extension of the Aerocity-Tughlakabad corridor and will improve the connectivity of the airport with the southern parts of Delhi, including Tughlakabad, Saket, Kalindi Kunj, etc.
Upon completion, the R.K. Ashram Marg to Indraprastha section will improve connectivity between West, North, Old, and Central Delhi. The remaining two sections will connect South Delhi with the domestic Airport Terminal-1 via Saket, Chattarpur, etc., thereby significantly boosting connectivity within the National Capital.
DMRC reported that Phase V(A) overall physical progress of 6.63 percent as of September 2026.
Delhi Metro Phase V (A) Station
Section | Line | Length (Km) | Station |
R.K. Ashram Marg to Indraprastha | Line 8 (Magenta Line) | 9.913 |
|
Aerocity to IGD Airport T-1 | Line 10 (Golden Line) | 2.263 |
|
Tughlakabad to Kalindi Kunj | Line 10 (Golden Line) | 3.9 |
|
Delhi Metro Phase V(B)
Phase V(B) comprises seven corridors totaling approximately 97.158 km and 65 stations, with an estimated cost of INR 48,204.56 crore. The Delhi government approved the plan in May 2026 and directed DMRC to prepare revised detailed project reports separately for priority and non-priority corridors; four priority corridors were targeted for completion by 2029.
Corridor | Length | Stations |
Dhansa Bus Stand - Nangloi | 11.859 km | 9 |
Central Secretariat - Kishangarh | 15.969 km | 10 |
Samaypur Badli - Narela | 12.89 km | 8 |
Kirti - Palam | 9.967 km | 6 |
Jor Bagh - Mithapur | 16.991 km | 12 |
Shastri Park - Mayur Vihar Phase III | 13.197 km | 8 |
Keshavpuram - Rohini Sector 34 | 16.285 km | 12 |
Delhi Metro Phase V Cost
The total estimated cost for the Delhi Metro Phase V (A) is INR 12014.91 crore (approximately USD 1.33 billion). It would be received from the Government of India, the Government of Delhi, and international funding agencies.
Phase V(B), the separate proposed 97-km expansion, has a reported estimated cost of INR 48,204.56 crore, but it is not yet centrally approved, so that figure is not a sanctioned Phase V cost.
Trusted by Leading Manufacturers & EPCs
Find The Latest Railway Infrastructure Projects In India
Gain exclusive access to our industry-leading database of Railway Infrastructure Project opportunities with detailed project timelines & stakeholder information
No credit card Up-to-date coverage
Delhi Metro Phase V Investors
Investors | Type |
Government of India | Equity/Grants |
Government of Delhi | Equity/Grants |
International Funding Agencies | Loans |
Benefits
The following are the benefits of the project:
Easy access: Aerocity to IGD Airport T-1 section improves connectivity to the airport, easing travel for daily commuters.
Boost connectivity: The Metro Line connects Tughlakabad to Kalindi Kunj, boosting south-east Delhi integration with the Golden Line.
Reduce CO2: The Metro Line reduces up to 33,000 tonnes of carbon dioxide annually by providing an alternative to cars.
Multiple Job Opportunities: The project generates over 5,000 direct jobs during its construction and operation phase. Furthermore, it adds indirect jobs in the real estate sector.
Increase total length: Upon completion, a Metro Line with approximately 400 km of total length will better handle peak loads in high-density areas.
Conclusion
Delhi Metro Phase V is a major expansion of the capital’s metro network. Developed in two phases, the project aims to improve connectivity in outer and densely populated areas of Delhi, reduce road congestion, and take the metro network beyond 400 km once Phase V(A) is completed.
Phase V(A) is an approved, funded, and active expansion with a 2029 completion target, while Phase V(B) is a much larger proposed expansion intended to bring metro connectivity deeper into Najafgarh, Narela, Rohini, Palam, Mithapur, and East Delhi. Together, they aim to improve last-mile access, support sustainable urban mobility, and reduce dependence on private vehicles across the National Capital.
Track the Latest Railway Infrastructure Projects in India for Business Opportunities
Subscribe to our upcoming and ongoing railway infrastructure projects in India to access reliable, high-quality insights on forthcoming and completed infrastructure projects across the country.
Our user-friendly platform provides essential details, timely updates, key stakeholder contact information, and business opportunities tailored for engineering companies, industry professionals, investors, and government agencies.
Start a free demo to take your business to the next level.
Leave a Comment
We love hearing from our readers and value your feedback. If you have any questions or comments about our content, feel free to leave a comment below.
We read every comment and do our best to respond to them all.
