Bangalore Chennai Expressway: Completion Date Updates
Bangalore Chennai Expressway

Project Profiles

Bangalore Chennai Expressway

Updated on Feb 06, 2026, 01:44 PM IST
Written by Siddhi Jain
Edited by Anandu Manoj

Table of Contents

  • Loading contents...

Project at a Glance

Project Name

Bangalore Chennai Expressway

Alternate Name

National Expressway 7 (NE-7)

Project Sector

Infrastructure

Project Type

Greenfield

Project Status

Under Construction

Construction Start Date

August 2019

Construction Completion Date

July 2026

Project Cost

INR 18,000 crore (USD 2.13 billion)

Project Developer

National Highway Authority of India (NHAI)

Expressway Speed Limit

120km/hr

Starting Point

Hoskote, Karnataka

Ending Point

Sriperumbudur, Tamil Nadu

Project Overview

The Bangalore Chennai Expressway is a four-lane (expandable to eight-lane) under-construction expressway developed by the National Highway Authority of India (NHAI). It is a 262 km-long expressway that starts in Hoskote, Karnataka, and ends at Sriperumbudur, Tamil Nadu.

Upon its operation (expected by July 2026), the expressway will connect Bangalore and Chennai (the Capitals of Karnataka and Tamil Nadu) in just three hours. Currently, it takes nearly 5-6 hours to cover the distance.

It is built in three phases, and its first phase consists of 15 major bridges, 47 minor bridges, 4 grade separators, 63 underpasses, 4 toll plazas, and 1 truck lay-by. The expressway also promotes the Chennai Bangalore Industrial Corridor, which aims to boost the area’s manufacturing sector.

Project Background

The Bangalore Chennai Expressway is also known as National Expressway 7 (NE-7). NHAI is developing it under the Bharatmala Pariyojana Programme. It is made under the Hybrid Annuity Model.

The project was proposed by the Ministry of Road Transport and Highways (MoRTH) in 2011, with the aim of economic and social growth. The progress was stopped due to the land acquisition and financing challenges.

The project was then finalized under the Bharatmala Pariyojana Programme in 2015. The land acquisition process started in December 2018 for 2,650 hectares of land. It was completed in January 2021, when it was designated a National Expressway. The bidding process began in November 2020, and the foundation stone was laid by Prime Minister Narendra Modi in 2022.

Bangalore Chennai Expressway Completion Date

The Bangalore Chennai Expressway is an under-construction project expected to open in July 2026. Initially, the expressway was expected to be operational by August 2025, but this was later extended to December 2025.

Project Cost

The total estimated cost for the construction of the Bangalore Chennai Expressway is approximately INR 18,000 crore (USD 2.13 billion). Out of this, approximately INR 5,700 crore (USD 672 million) will be used for construction. The remaining will be used for land acquisition, toll-gate mechanism, project administration, etc.

40+ reviews

Find the Latest Road Infrastructure Projects In India

Gain exclusive access to our industry-leading database of infrastructure project opportunities with detailed project timelines and stakeholder information.

​Collect Your Free Leads Here!

No credit cardUp-to-date coverage

Joined by 750+ industry professionals last month

Bangalore Chennai Expressway Route Map

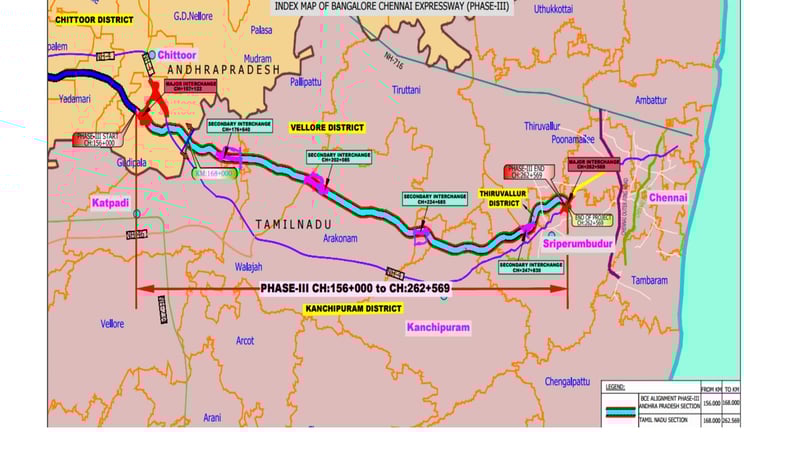

Bangalore Chennai Expressway Map

Bangalore Chennai Expressway Route

The 262 km-long expressway starts from Hoskote, Karnataka, and ends at Sriperumbudur, Tamil Nadu. It passes through three states - Karnataka, Andhra Pradesh, and Tamil Nadu.

It passes through several cities and villages, including Hoskote, Malur, Bangarapet, Kolar Gold Fields, Venkatagirikota, Palamaner, Bangarupalem, Chittoor, Ranipet, and Sriperumbudur.

Project Timeline

Year

Event

July 2026

Expected completion date of the project

December 2024

71 km Karnataka stretch completed

2023

Initial construction completion date

2022

Prime Minister Narendra Modi laid the foundation stone

November 2020

2,650 hectares of land were acquired, and tenders for three packages were invited

August 2019

Construction work started on the expressway

December 2018

Land acquisition work started

2015

The project was finalized under the Bharatmala Pariyojana Programme

2011

The project was proposed by the Ministry of Road Transport and Highways (MoRTH)

Bangalore Chennai Expressway Phases

The  Bangalore Chennai Expressway is to be built in three phases and ten packages. Below follows a detailed description of each of the following:

Phase I

Phase I of the expressway is built in Karnataka and is approximately 71 km long. It comprises 15 major bridges, 47 minor bridges, 4 grade separators, 63 underpasses, 4 toll plazas, and 1 truck lay-by.

It has been operational since December 2024, improving accessibility to Malur and Bangarpet from Bangalore.

Phase II

Phase II of the expressway in Andhra Pradesh covers approximately 85 km. It has three packages and is currently under construction. Below is a detailed description of its packages and contractors:

Phase III

The total length of the expressway in Tamil Nadu is approximately 106.1 km. Also, the section will have three rest areas, two truck lay-by areas, 34 major bridges, 31 minor bridges, three rail overbridges, and three interchanges.

Bangalore Chennai Expressway Packages & Contractors

Phase

Packages

Length (Km)

Contractors

Phase I

Hoskote-Malur

26.4

Dilip Buildcon

Malur-Bangarapet

27.1

Dilip Buildcon

Bangarapet-Bethamangala

17.5

KCC Buildcon

Phase II

Bethamangala-Baireddipalle

25.0

Montecarlo

Baireddipalle-Bangarupalem

31.0

APCO Infratech

Bangarupalem-Gudipala

29.0

Dilip Buildcon

Phase III

Gudipala-Walajapet

24.0

Montecarlo

Walajapet-Arakkonam

24.5

KCC Buildcon

Arakkonam-Kanchipuram

25.5

DP Jain Infra

Kanchipuram-Sriperumbudur

32.1

RCC

40+ reviews

Find the Latest Road Infrastructure Projects In India

Gain exclusive access to our industry-leading database of Infrastructure opportunities with detailed project timelines and stakeholder information.

​Collect Your Free Leads Here!

No credit cardUp-to-date coverage

Joined by 750+ industry professionals last month

Bangalore Chennai Expressway Toll Rates

The tolls are expected to be collected at four sections:

  1. Hedigenabele

  2. Sudarpalaya

  3. Agrahara

  4. Krishnarajapura

The toll rates from Hedigenabele to Sudarpalaya are discussed below:

Vehicle Type

Hedigenabele to Sundarpalya

Sundarpalya to Hedigenabele

Return Trip (In a Single Day)

Car/Jeep

INR 185

INR 190

INR 275-280

Minibuses

INR 295

INR 305

INR 445-455

Trucks/Buses

INR 620

INR 635

INR 930-955

Monthly Passes

INR 6,105

INR 6,260

        -

Benefits

The following are the benefits of the expressway:

  • Reduce travel time: With a high speed of 120km/hr, the expressway reduces travel time from 6-8 hours to 2-3 hours.

  • Boosting Trade & Logistics: The expressway provides a short and hassle-free travel option, ultimately enhancing freight transportation efficiency.

  • Encourages multiple businesses: Providing smooth freight transportation, the expressway boosts businesses across sectors such as electronics, automobiles, and manufacturing.

  • Boost Economy: The expressway strengthens the Bengaluru-Chennai link, fostering trade, IT collaboration, and faster goods transport, while supporting the Chennai-Bangalore Industrial Corridor (CBIC) for manufacturing, electronics, and logistics hubs.

  • Lifts Real Estate: Increases property rates along the route (Hoskote, Sriperumbudur), thereby unlocking residential, commercial, and industrial development in areas such as Hoskote Road and Bangalore East.

  • Community development: The expressway strengthens infrastructure integration with routes such as NH-75 and NH-648, promotes environmental measures, including animal underpasses, and reduces congestion on existing highways.

Conclusion

The four-lane (expandable to eight-lane) Bangalore Chennai Expressway is a National Highway Authority of India (NHAI) project developed to reduce travel time from Bangalore to Chennai to just 2-3 hours. Also known as National Expressway 7 (NE-7), the 262 km-long expressway runs from Hoskote, Karnataka, to Sriperumbudur, Tamil Nadu.

Developed under the Bharatmala Pariyojana Programme in the Hybrid Annuity Model, the expressway became a regional infrastructure milestone. It fosters economic corridors, industrial growth, and regional connectivity across Karnataka, Andhra Pradesh, and Tamil Nadu.

In the end, the project catalyzes the Chennai-Bangalore Industrial Corridor, improving trade, fostering IT collaboration, and boosting real estate in areas such as Hoskote and Sriperumbudur.
