Baltic Eagle Offshore Wind Farm Germany – Capacity, Cost & Latest Updates

project_profile

Baltic Eagle Offshore Wind Farm Germany – Capacity, Cost & Latest Updates

Updated on Jun 01, 2026, 09:52 AM IST
Written by Sarthak



Project at a Glance







Project Name





Baltic Eagle Offshore Wind Farm





Project Type





Greenfield





Project Location





North-East of the Island of Rügen, Germany





Sector





Energy





Subsector





Wind Energy





Project Value





EUR 1.6 billion (USD 1.76 billion)





Project Status





Under Construction





Project Developer





Iberdrola





Owners





Masdar and Iberdrola





Capacity





476 MW





Construction Start Date





2022





Project Completion Date





End of 2024





Project Overview

The Baltic Eagle Offshore Wind Farm is a renewable energy project under development in the German Baltic sea. It is located 26.6 kilometers northeast of the Island of Rügen. After completion at the end of 2024, the 476 MW project will be one of the largest offshore wind farms in Germany.

Trusted by Leading EPCs & Manufacturers

Find Offshore Wind Projects in Germany

Discovering and tracking projects and tenders is not easy. With Blackridge Research's Global Project Tracking (GPT) platform, you can identify the right opportunities and grow your pipeline while saving precious time and money doing it.

Request Free Trial → Learn More →

No credit card Up-to-date coverage



The offshore wind project was started in 2022 and will be commissioned by the end of 2024. The wind farm will generate enough clean energy to power approximately 475,000 households and contribute to Germany’s energy transition.



The Baltic Eagle project developed by Iberdrola is valued at EUR 1.6 billion (USD 1.76 billion). In 2023, Masdar became a co-owner of the offshore wind farm project.



Project Background

The Baltic Eagle wind farm is central to Iberdrola's Baltic Hub in Germany. This portfolio of offshore wind projects on the German Baltic coast has a combined capacity exceeding 1.1 GW. The total hub has a projected total investment of EUR 3.7 billion.



The Baltic Hub includes the Baltic Eagle offshore wind farm, the 350 MW Wikinger wind farm (operational since 2017), and the upcoming 300 MW Windanker wind farm (completed by 2026).



Baltic Eagle Offshore Wind Farm



In March 2018, Iberdrola received rights to develop and operate the Baltic Eagle from the Federal Network Agency. The wind farm is located within the area awarded under the Federal Network Agency's transitional tender framework.



Construction of the offshore wind farm started in April 2022 after approvals from the German Federal Maritime and Hydrographic Agency (BSH).



In November 2023, Iberdrola and Abu Dhabi state owned Masdar signed an agreement of EUR 1.6 billion with Iberdrola holding a 51% majority stake in the project. This partnership will accelerate the transition to offshore wind energy in Europe. In December 2023 Van Oord successfully completed the installation of all 50 foundations and inter-array cables. The first turbine's installation in May 2024 started the final phase of construction.



Project Location Details

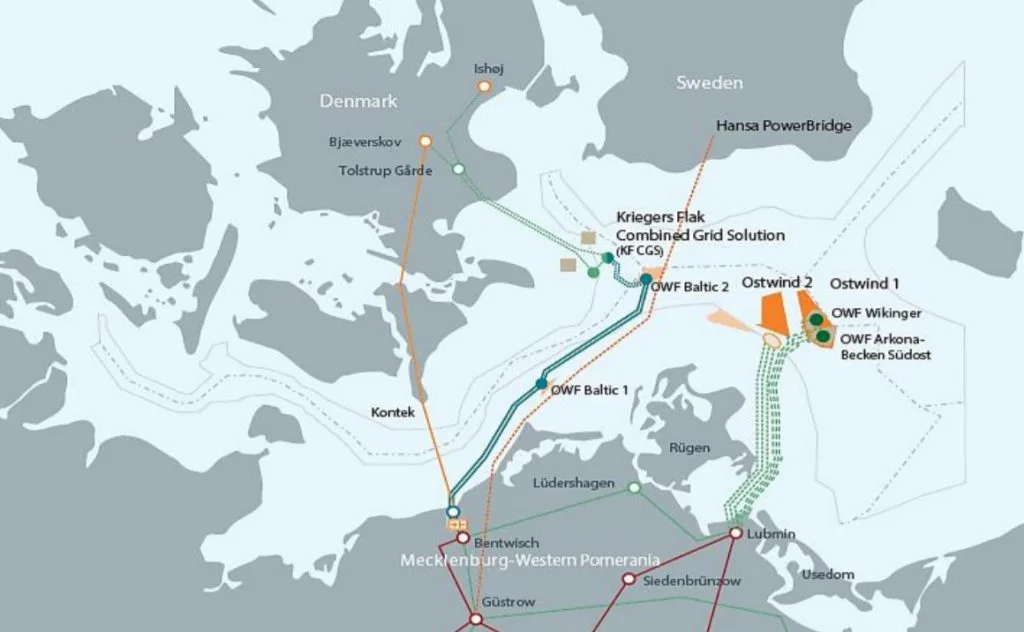

Baltic Eagle offshore wind farm location map

Baltic Eagle location map



The Baltic Eagle offshore wind farm is located in the German Exclusive Economic Zone (EEZ) of the Baltic Sea about 27.6 km northeast of Rügen island. The project area is 42.9 km² and the water depths are between 41 and 45 m.



Project cost

The estimated project cost of the Baltic Sea offshore wind farm is EUR 1.6 billion (USD 1.76 billion).



Technical Specifications

The Baltic Eagle Offshore Wind Farm features 50 V174-9.4 MW MHI Vestas offshore wind turbines. These turbines are the most advanced in the industry, with a rotor blade diameter of 174 meters and a swept area of 23,778 square meters.



Each turbine is mounted on a monopile foundation with diameters ranging from 8.75 to 9 meters, lengths between 75 and 90 meters, and maximum foundation weights reaching up to 1,402 tonnes.

Trusted by Leading EPCs & Manufacturers

Find Offshore Wind Farm Project in Germany

Discovering and tracking projects and tenders is not easy. With Blackridge Research's Global Project Tracking (GPT) platform, you can identify the right opportunities and grow your pipeline while saving precious time and money doing it.

Request Free Trial → Learn More →

No credit card Up-to-date coverage



With a turbine height of 107 meters, Baltic Eagle became one of the largest offshore wind projects taken by Vestas in Germany. The electricity generated by the turbines will be collected by an onsite-offshore substation, which will convert the voltage from 66 kV to 220 kV before transmitting it to the mainland.



This power will then travel through two 90-kilometer-long high-voltage subsea cables to the onshore platform located in Lubmin. In May 2020, Heerema Marine Contractors installed a substructure, 8 foundation piles and a 5-deck topside.



The substation operated by 50Hertz acts as the critical connection point between the offshore wind farm and the power grid in north-eastern Germany. It contains the necessary transformers and electrical equipment to ensure efficient power transmission. The connection infrastructure is designed to feed the clean energy generated by Baltic Eagle directly into the German power grid.



Contractors Involved



Contractor





Role





MHI Vestas Offshore Wind





Wind Turbine Supplier





Fred. Olsen Windcarrier (FOWIC)





Transportation and Installation of Wind Turbines





Iberdrola





Project Owner





EEW Group Special Pipe Constructions (EEW SPC)





Monopile Fabrication





Windar





Transition Piece Fabrication





Van Oord





Foundation Installation, Cable Laying





TKF





Inter-Array Cable Supply





50Hertz





Offshore Substation Construction and Installation





Iemants-Fabricom





Substation Structural Elements





Heerema





Substation Transportation and Installation





Siemens Gas and Power





Offshore Substation Electrical Equipment





Vos Prodect





Sealed Cable Hang-Off Systems





EDS HV Group





High Voltage Safety Management Commissioning





Fraunhofer IWES





Boulder Detection and Geohazard Survey





AqualisBraemar LOC





Marine Warranty Survey





Tekmar Energy





Cable Protection System

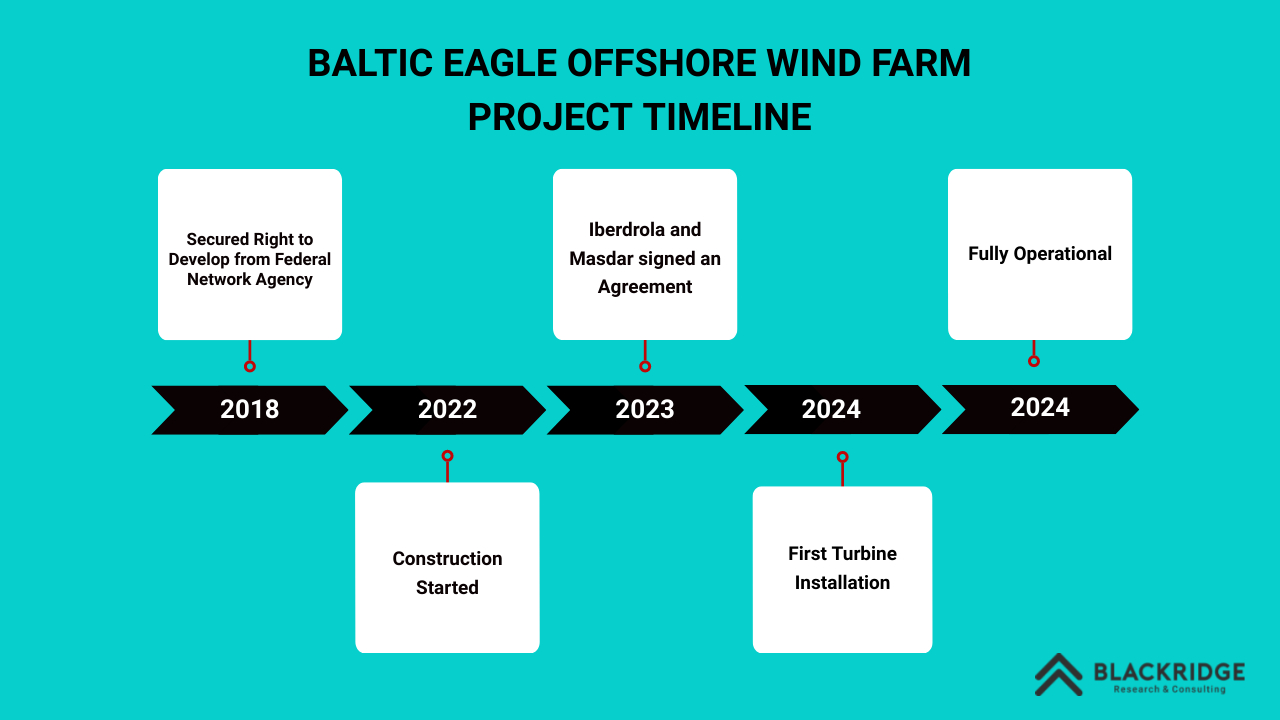

Project Timeline

Baltic Eagle offshore wind farm project timeline



Project Benefits

The Baltic Eagle Offshore Wind Farm brings economic, environmental, and industrial benefits to Germany. The project will create high-quality jobs throughout the offshore wind value chain, from manufacturing and installation to operation and maintenance (O&M). The offshore wind project will also contribute to the reindustrialization and modernization of shipyards across Europe.



Environmentally, Baltic Eagle will generate approximately 1.9 TWh of clean electricity annually. This will be sufficient to power approximately 475,000 homes. The project will reduce carbon emissions by offsetting 800,000 tonnes of CO2 into the atmosphere each year.



Current and Future Outlook

As of mid-2024, half of the 50 wind turbines have been successfully installed at the Baltic Eagle OWF (offshore wind farm).



Husain Al Meer, Director, Global Offshore Wind at Masdar said: “We are delighted that, together with Iberdrola and Vestas, we have taken this significant step toward making the landmark Baltic Eagle wind farm a reality. Masdar has a long-standing commitment to advancing offshore wind projects across the globe."



The project is on track for full construction and commissioning by the end of the year. The project has secured multiple power purchase agreements (PPAs), including deals with major companies like Amazon and German steel manufacturers Dillinger and Saarstahl.



Conclusion

The Baltic Eagle Offshore Wind Farm is a flagship project in Germany's renewable energy transition. Using the potential of offshore wind, the project will drive economic growth, environmental sustainability, and energy independence. Developed by Iberdrola in partnership with Masdar, this 476 MW project will play a pivotal role in the Baltic Hub. As construction progresses toward completion by the end of 2024, Baltic Eagle will be one of Europe's major renewable energy projects.



Connect with decision-makers of offshore wind projects in Germany for business opportunities.

Subscribe to our offshore wind projects database in Germany and receive exclusive benefits like

  • Regular updates on offshore projects and tenders

  • In-progress and Completed offshore wind projects

  • Essential details, Timely Updates, Key Stakeholder Contact Information

  • Industry Trends and insights by experts



Start a free demo to find the latest Germany's offshore wind farm projects to take your business to the next level!
