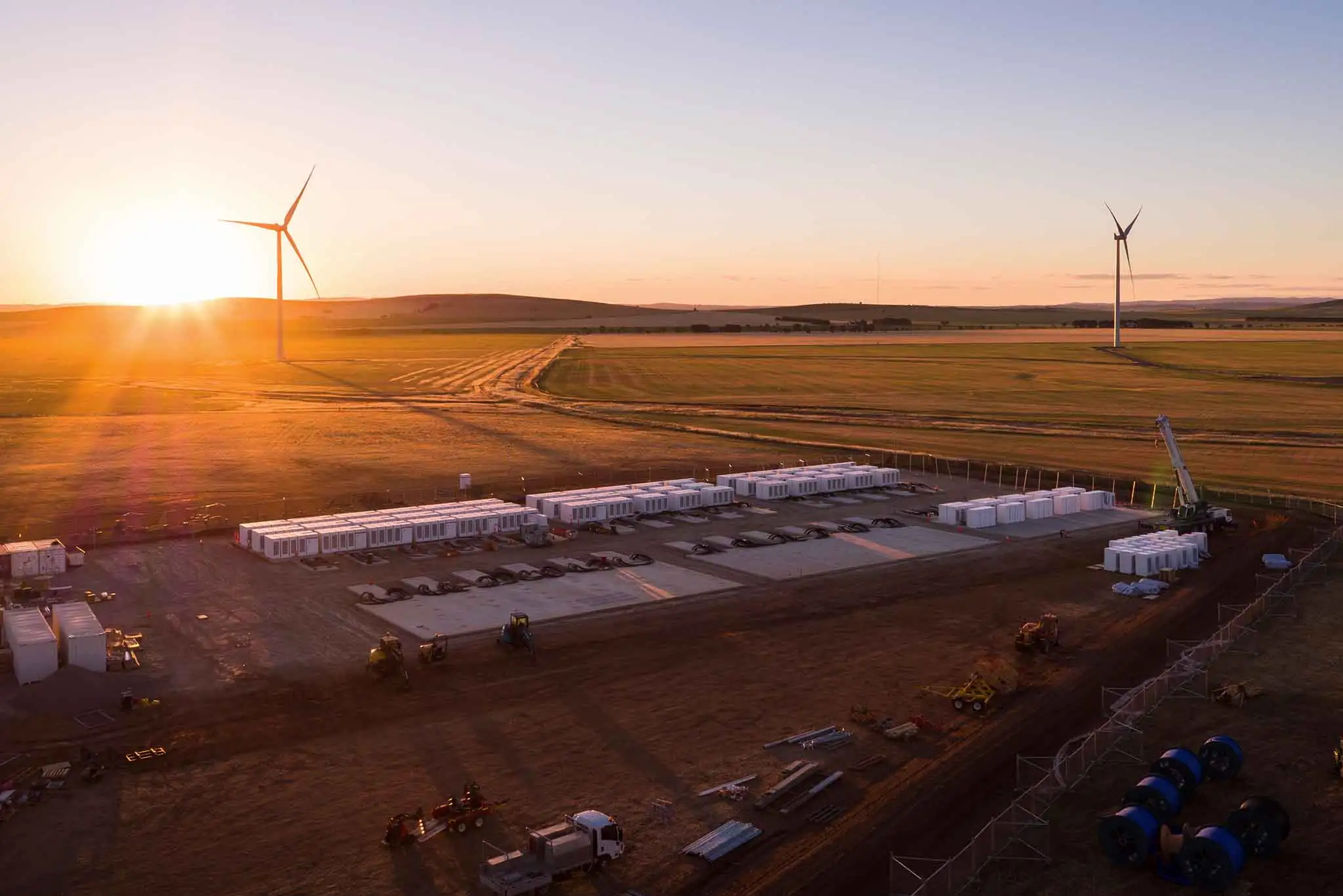

| Project at a Glance | |
|---|---|
| Project Name | Hornsdale Power Reserve |
| Project Type | Greenfield |
| Project Location | South Australia |
| Sector | Energy |
| Sub sector | Power Reserve |
| Project Value | AUD 90 million (Phase -1) AUD 109 million (Expansion Phase) |
| Project Status | Completed/Commissioned |
| Project Developer/Coordinator | Neoen and Tesla |
| Project Completion Date | 2017 |
| Expansion Project Completion Date | 2020 |
| Special Mention | Australia's largest lithium-ion battery power reserve |
Project Overview

The HPR (Hornsdale Power Reserve) is the world's first large-scale battery system. It offers crucial grid-support services.
It was developed by a consortium of Neoen, a French renewable energy firm and Tesla, the largest electric car manufacturer in the world. However, Neoen owns and operates the facility.
The main purpose of the battery is to improve the stability and security of the South Australian electrical supply. It helped integrate renewable energy into South Australia. It also contributed to a decrease in power outages.
The original 100 MW (129 MWh) project was completed in November 2017. The Hornsdale Power Reserve extension of 50 MW (64.5 MWh) was completed in September 2020.
Read: Eku Energy Starts the Construction of 130 MWh BESS Projects in UK
Project Background
In September 2016, South Australia was hit by severe storms. It damaged homes and important infrastructure, including more than 20 energy transmission towers. As a result, the communication lines got damaged. It caused a number of wind farms to shut down. There was a rapid shortage of power.
Find BESS Projects and Tenders in Australia Get Started Now!
South Australia started getting more power from Victoria through the Heywood interconnector. The extra power that was being sent overloaded the interconnector, and it was turned off. This resulted in power cuts for the whole state of South Australia. A significant portion of the state lost power for several hours.
More power outages and load-shedding happened between September 2016 and February 2017. This made the South Australian government execute a policy plan to fix problems with the power supply. In March 2017, the SA government reacted to the "energy crisis" by announcing the Energy Plan. It was an AUD 550 million plan to improve energy security in the state. The plan included building Hornsdale Power Reserve, Australia's largest battery storage project.
Read: SECI Launches India's Largest Battery Energy Storage System in Chhattisgarh
Project Timeline
Important dates in the project timeline are given below:
| DATES | EVENTS |
| 28 September 2016 | Storms led to a substantial and prolonged power outage in South Australia. |
| 9 March 2017 | A Twitter conversation between Elon Musk and Atlassian founder Mike Cannon-Brookes increases battery interest. Elon Musk promises “100 days from contract signature or it is free”. |
| 14 March 2017 | The SA Government launches an AUD 550 million energy plan to improve grid resilience. This includes installing a 100 MW battery before the 2017/18 Australian summer. |
| 16 March 2017 | The South African Government starts a two-step competitive bidding process for companies from around the world interested in building the 100 MW battery. The first step is an Expression of Interest, which brings in 79 applicants. The second step is an Invitation to Supply, with 14 shortlisted applicants. |
| 6 July 2017 | The Hornsdale Power Reserve (HPR) group is given the job of building the Battery. Neoen leads the consortium, which employs Tesla's battery equipment. The Project Agreement is signed. |
| 29 September 2017 | The Australian Energy Market Operator approves the grid connection agreement with ElectraNet, the energy transmission network operator. Musk's 100-day challenge begins. |
| 1 December 2017 | The battery is built and connected to the NEM before the 100-day deadline. |
| 18 December 2017 | The Battery first responds to grid stabilization issues when a New South Wales coal generator shuts down. Battery responds to a sudden outage of 689 MW of power in a fraction of a second, faster than any other generation technology. |
Location Details
The HPR is located in South Australia's Mid-North area. It's about 15 km north of Jamestown and a three-hour drive from Adelaide. It is right next to Neoen's Hornsdale Wind Farm.
The power reserve covers an area of 2.471 acres. The location is quite important due to the abundant wind energy accessible in that area. It will help the power reserve in capturing energy.
Project scope
The Hornsdale Power Reserve is the world's strongest lithium-ion battery. It includes a 150 MW (194 MWh) grid-connected energy storage facility operated by Neoen and located adjacent to the Hornsdale Wind Farm. The initial phase, which included a 100 MW (129 MWh) project, was completed in a record-breaking 100 days and proved effective in terms of electricity cost savings. Considering the multiple benefits offered by the initial project, a 50 MW (64.5 MWh) expansion project was initiated in 2019 and completed in 2020.
The battery uses Tesla powerpack lithium-ion modules. Each power pack is a direct current energy storage device. It contains 16 independent battery pods. Almost 5 powerpacks generate 1 megawatt hour of electricity. The battery consists of hundreds of linked powerpack towers.
The battery can power 30,000 homes. The battery's 129 MWh capacity delivers approximately 75 minutes of electricity at full discharge. It uses the same 275 kV network connection point as the 300 MW Hornsdale Wind Farm. It acts as a charging source and supplies electricity during peak hours to ensure system security.
Read: Masdar Arlington Energy Breaks Ground on Two BESS Projects as a Part of $1.27 Billion Investment
Project Cost
The cost of the initial phase of the project was AUD 90 million. The SA Government decided to pay AUD 41.8 million over the course of the project agreement for battery storage services. This money came from its AUD 150 million Renewable Technology Fund. According to the project agreement, the SA government paid the HPR group every month. In return, the HPR group gave the government the sole right to use a reserved 70 MW power output capacity and a reserved 10 MWh energy storage capacity. The remaining extra space in the battery could be sold to the NEM by the HPR consortium in order to generate additional revenue.
The expansion project cost was AUD 108.39 million which included the following,
- AUD 22.90 million from the state government
- AUD 12.21 million from ARENA - Australian Renewable Energy Agency
- Up to AUD 76.33 million from CEFC- Clean Energy Finance Corporation in cheap loans
Read: Why is BESS Needed to Harness the Maximum Potential of Solar Energy
Contractors Involved
The contractors involved in the Hornsdale Power Reserve project were Neoen and Tesla. Neoen, a French renewable energy firm, led the consortium responsible for constructing the battery. In 2019, Neoen announced to expand the capacity by an additional 50 MW/64.5 MWh. This resulted in bringing the total combined capacity to 193.5 MWh.
Tesla, on the other hand, was awarded the contract in July 2017 to construct the initial 100 MW/129 MWh lithium-ion battery. Additionally, in November 2019, Tesla signed an agreement with Neoen to provide a 50 MW/64.5 MWh lithium-ion battery for the power reserve expansion.
These two companies played crucial roles in the development and expansion of the Hornsdale Power Reserve, showcasing their expertise in renewable energy and battery technology.
Benefits of the Project
Here are some of the benefits associated with this project,
SIGNIFICANT COST SAVINGS
Aurecon independently assessed Big Battery performance in 2018 and 2019. The studies proved how the project promotes the NEM and saves all electricity customers. The battery saved AUD 176.96 million in 2019 by providing Frequency Control Ancillary Services.
IMPACT ON COSTS
The study shows the battery's rapid response when South Australia is disconnected from the grid. On November 16, 2019, the state was isolated owing to an interconnector failure, leading to heightened market volatility and frequency. The Big Battery quickly restored the energy system frequency, resulting in savings of AUD 21.36 million for consumers.
PREVENTING BLACKOUTS
South Australian blackouts are prevented by Hornsdale Power Reserve. It responds rapidly and correctly to grid frequency changes that would have previously caused blackouts. When SA is separated or ‘islanded’ from the grid, the battery keeps the lights on and the system stable. This has happened several times since the battery was used.
Read: Finish Utility Helen is Launching a 40 MW Battery Energy Storage Project in Finland
Conclusion
Neoen's Hornsdale Power Reserve is an innovative energy storage facility. It deals with the grid stability issues in South Australia. This is the largest reserve of lithium-ion batteries in the world. The grid-scale batteries offer essential support services for the power grid, showcasing their usefulness in stabilizing power networks.
The project is backed by a strategic alliance between Neoen, Tesla, and governmental organizations. It demonstrates cooperative endeavors to create enduring energy solutions. It exhibits exceptional performance and technological advancements. The Hornsdale Power Reserve is a prominent model for large-scale energy storage initiatives worldwide. It also contributes to establishing a more resilient and enduring energy future.
Read: Ireland Opens its Largest Battery Energy Storage at Dublin Energy Hub
Discover the Latest Battery Energy Storage System (BESS) Projects in Australia with Ease
Are you looking for a platform that gives you reliable, high-quality, and timely project insights for the latest Find the Latest Battery Energy Storage System (BESS) Projects in Australia?
Discover the Global Project Tracking (GPT) platform by Blackridge Research, designed to provide you with the most recent updates regarding Battery Energy Storage System (BESS) Projects in Australia and faster across various stages of development:
- Upcoming projects
- Tender Notices
- Contract award announcements
- Projects in progress or under construction
- Successfully completed projects.
The user-friendly interface helps you obtain early-stage awareness of projects and find the right business opportunity quickly.
With its user-friendly interface, this platform empowers you to gain early-stage awareness of projects and swiftly identify the right business opportunities.
Each project will have all the essential details, such as scope, capacity, CapEx, status, project description, companies involved, funding information, location, periodic updates, important event dates like construction start date, commissioning dates, and key contact information of project owners and stakeholders.
The database is a vital resource for a wide range of entities, including energy storage companies, battery companies, facility operation and maintenance (O&M) companies, consulting and advisory firms, investors, investment firms, project finance agencies, research and development organizations, regulatory bodies, and law firms.
Book a Free demo to learn more about the Battery Energy Storage System (BESS) Projects and Tenders database and how we can help you achieve your goals
Leave a Comment
We love hearing from our readers and value your feedback. If you have any questions or comments about our content, feel free to leave a comment below.
We read every comment and do our best to respond to them all.
